What are the Risk Ratings?

How Risk Ratings are determined and defined in Onside

When setting up your risk register, each risk you add will have a 'Manage' section, and within this, the "Inherent risk rating" for that risk, as well as a "Residual risk rating".

These ratings are important because they advise you and your staff what level of action needs to be taken and how urgently. You would treat a low risk very differently to a critical risk after all.

The risk severity rating calculation is based on the Consequence and Likelihood chosen, as per the matrix shown below.

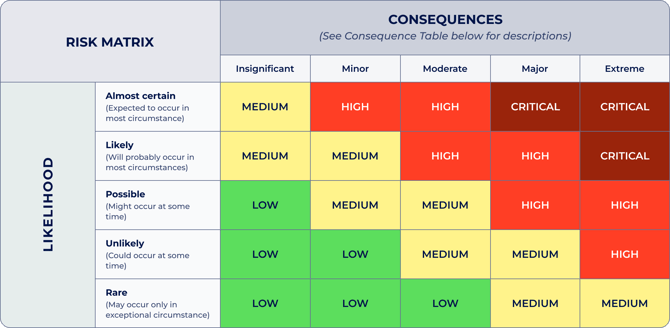

Risk matrix


Definitions of the consequences

Listed below are how each of the consequence levels are defined.
We've included two approaches here - Health and Safety, as well as Environmental.

As you add control measures for your risks, your 'Residual risk rating' should be updated to reflect those changes.

An example of this could be an effluent pond risk; if it's possible someone could enter it, the consequence could be extreme, so it has an Inherent risk rating of 'High'. If you were to then adequately fence the pond and put up signage, the likelihood of someone entering the pond would be 'Rare', in which case the Residual risk rating would be 'Medium'.

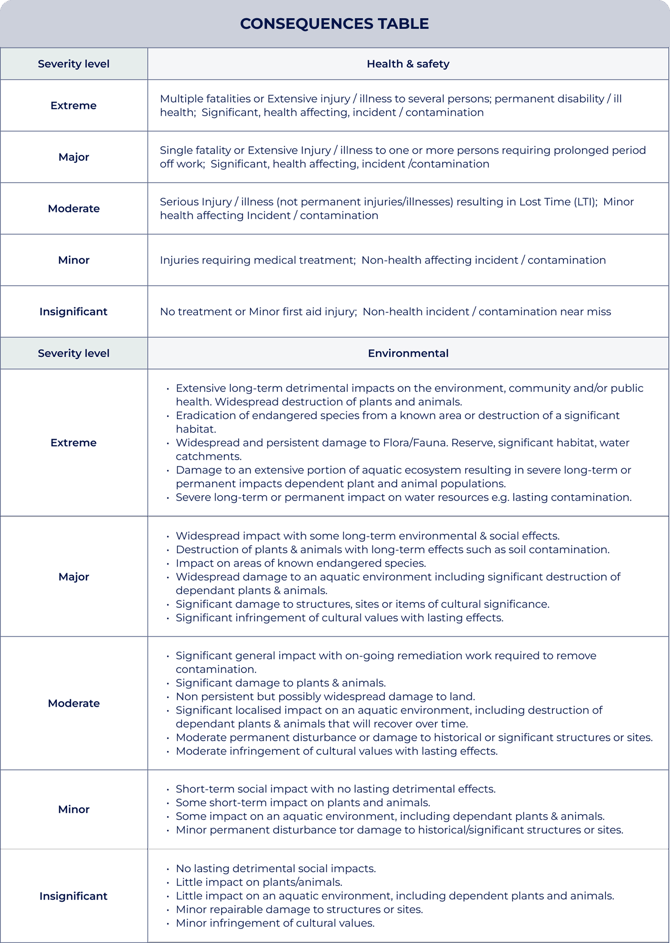

Consequences table




What should I do for each severity rating?

Critical Immediate action - isolate scene - investigate, controls. Eliminate, substitute or engineering controls. Resolve within 24 hours
High Act immediately to mitigate the risk. Either eliminate,  substitute, or engineer controls. If these controls cannot be implemented immediately, set a timeline and put interim risk reduction plans in the meantime. Apply time to resolve. Resolve within 2 weeks
Medium Take reasonable steps to mitigate the risk, with elimination, engineering, substitution, administrative or PPE controls. Lower level controls should not be considered a permanent strategy and must be reviewed at least bi-annually.  Resolve within 1 month
Low Take reasonable steps to mitigate and monitor the risk. Permanent controls can be administrative in nature. Resolve as practical, within 2 months

For a more in-depth look at legislation around control measures, as per the New Zealand Health and Safety at Work (General Risk and Workplace Management) Regulations 2016, click here.
